Industrial Facility Mat Pour Solution
Lindblad Construction: Large-Scale Pour Success in South Chicago
Lindblad Construction, in partnership with Walsh Construction, needed to complete a nearly 2,000 cubic yard continuous mat foundation pour at an operational industrial plant in South Chicago within a single day. The project demanded strict adherence to safety protocols, precise timing, and coordination across multiple concrete plants. Ozinga provided comprehensive planning, coordination, and execution support to deliver 185 loads of concrete with zero rejected loads and no safety incidents.



Lindblad Construction is a general contractor known for handling complex industrial projects that require meticulous planning and execution. Working in partnership with Walsh Construction on an industrial facility project in South Chicago, Lindblad faced one of their most logistically demanding concrete pours to date. The project required pouring a continuous mat foundation in a single day at an active industrial facility with strict operational requirements and limited site access.
The Challenge

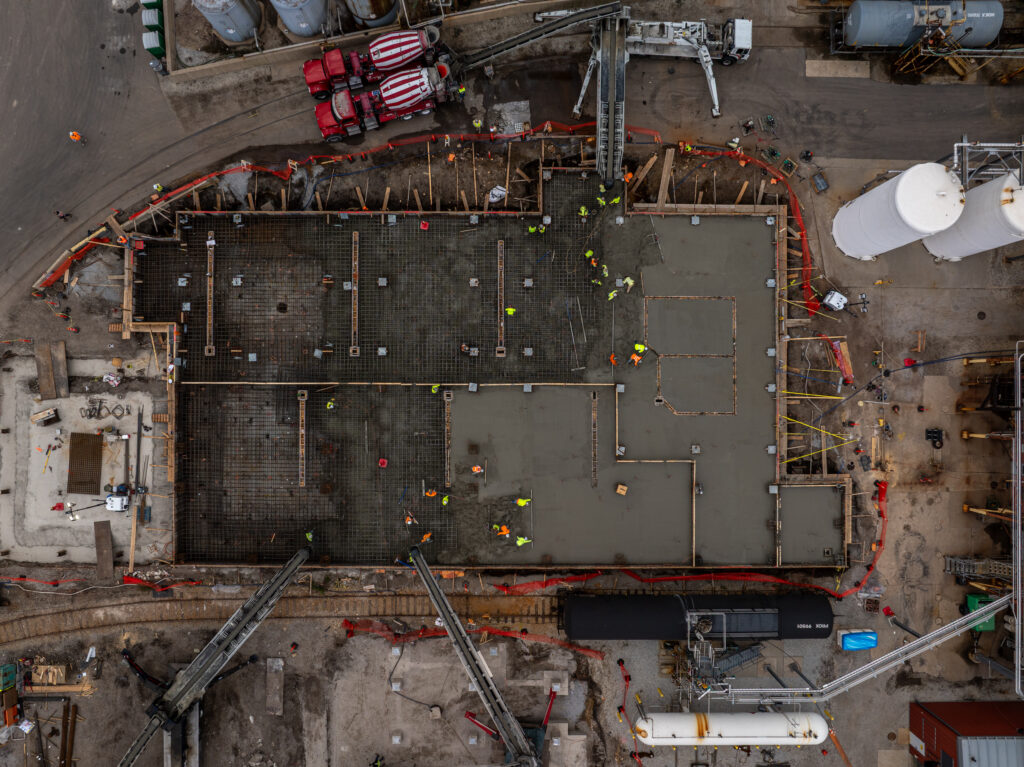

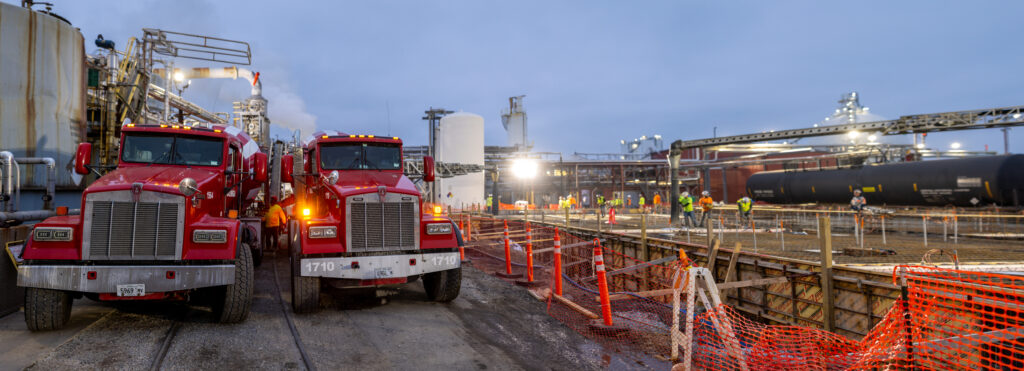

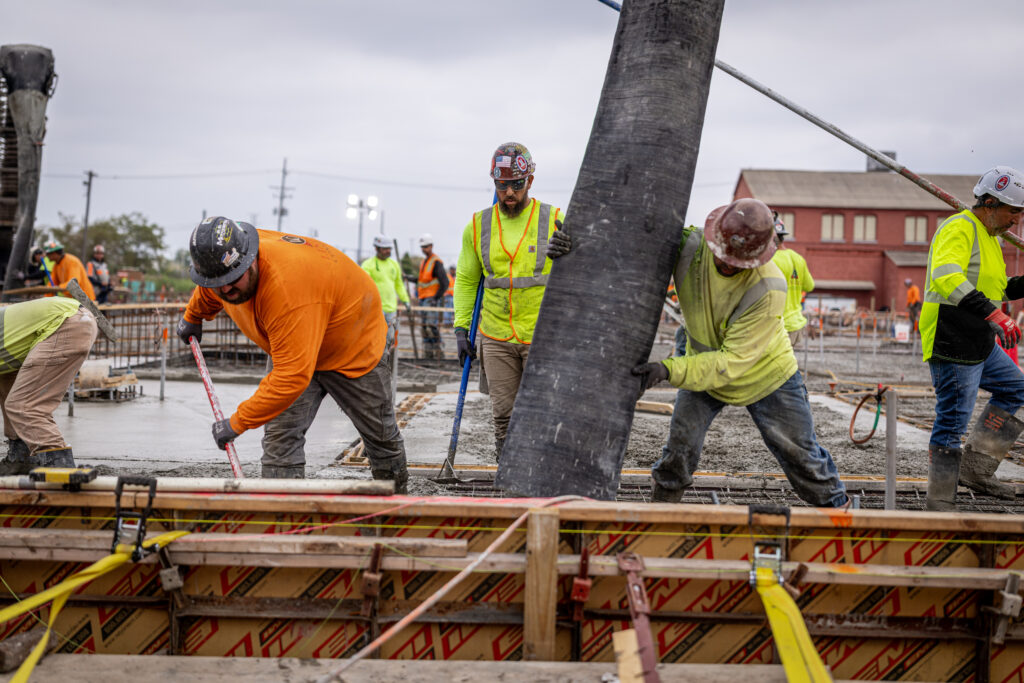

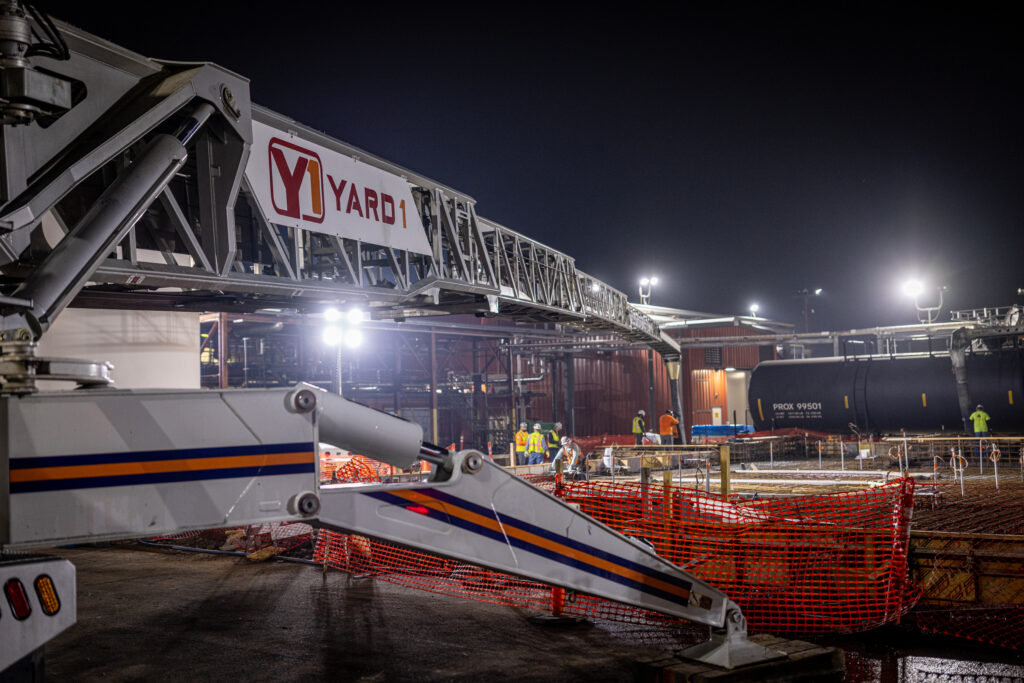

The continuous mat foundation pour presented multiple interconnected challenges that required careful coordination and planning. Lindblad Construction needed to pour nearly 2,000 cubic yards of concrete beginning at 5:00 AM and continuing throughout the day without interruption. This large volume of material would be placed using four conveyors from concrete conveyor and pump experts Yard1.

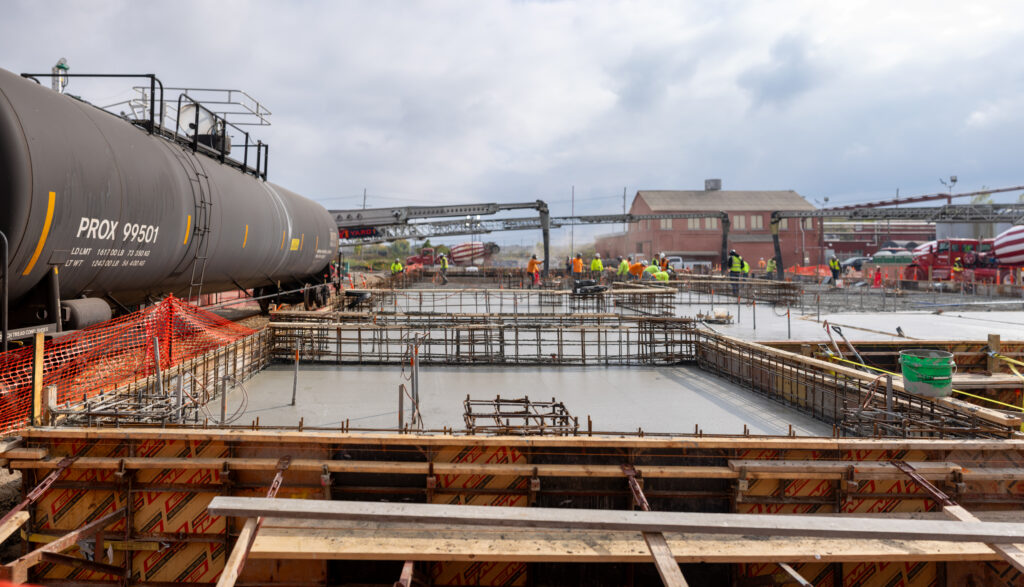

The operational environment added significant complexity to the project. The industrial facility remained active during construction, creating a dynamic work environment with considerable activity surrounding the pour site. Access to and from the facility was severely restricted, requiring careful navigation and timing. This South Chicago plant also has several rail access points to work around. Safety protocols were paramount, with specific guidelines governing every aspect of the operation.
The timeline was extremely tight, demanding attention to truck spacing and logistics detail from start to finish. Any disruption in the concrete supply, rejected loads, or safety incidents would jeopardize the entire project. Lindblad needed a concrete supplier who could deliver reliable service while navigating these complex logistical and operational constraints, adjusting throughout the day as needed.

The Solution
Ozinga approached this project with comprehensive planning and coordination across all operational areas. Recognizing the scale and complexity of the pour, Walsh and Lindblad conducted extensive pre-pour meetings that brought together project managers, superintendents, dispatchers, safety personnel, quality control specialists, account managers, and operations staff. This collaborative approach ensured that every team member understood the project requirements and their role in successful execution.

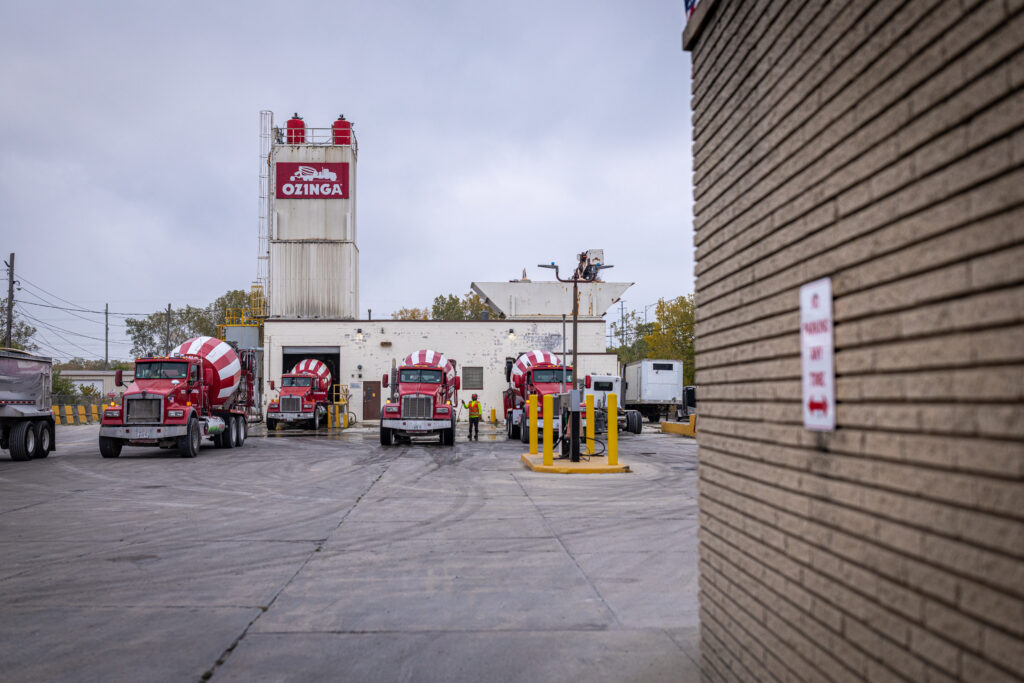

To meet the high volume demand and early start time, Ozinga coordinated operations across three separate concrete plants. These plants opened earlier than normal operating hours to ensure concrete delivery could begin promptly at 5:00 AM and maintain a steady supply throughout the day.

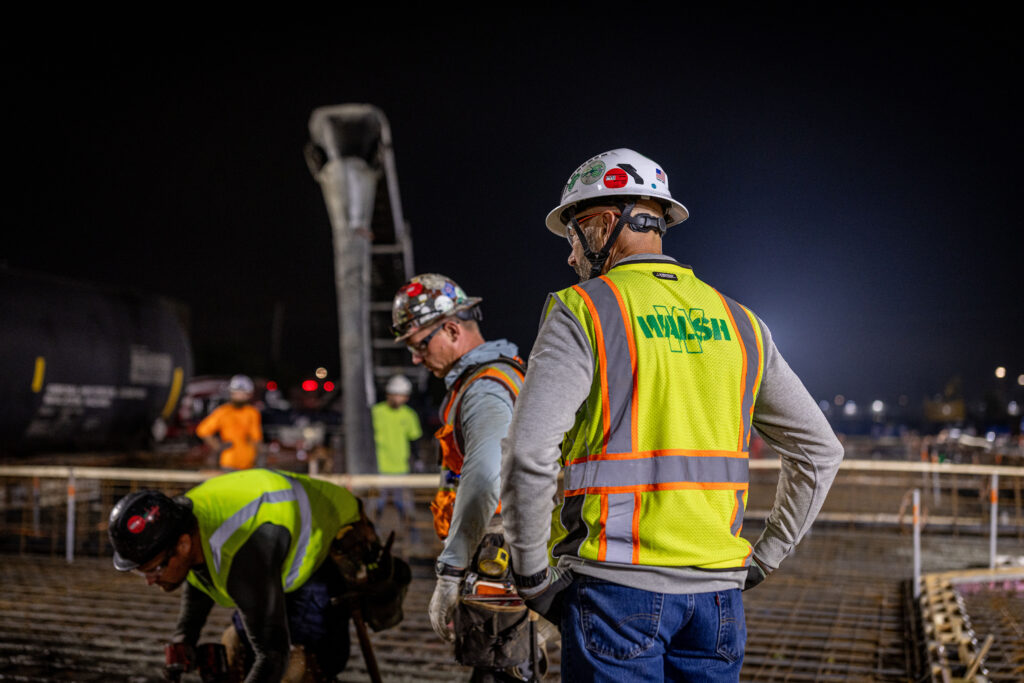

Ozinga’s team worked closely with Lindblad Construction to develop detailed logistics protocols for the challenging site conditions. Drivers received specific instructions for entering and exiting the facility, positioning at concrete conveyors, and navigating through the active industrial environment. These protocols addressed the strict safety guidelines while ensuring efficient material flow.

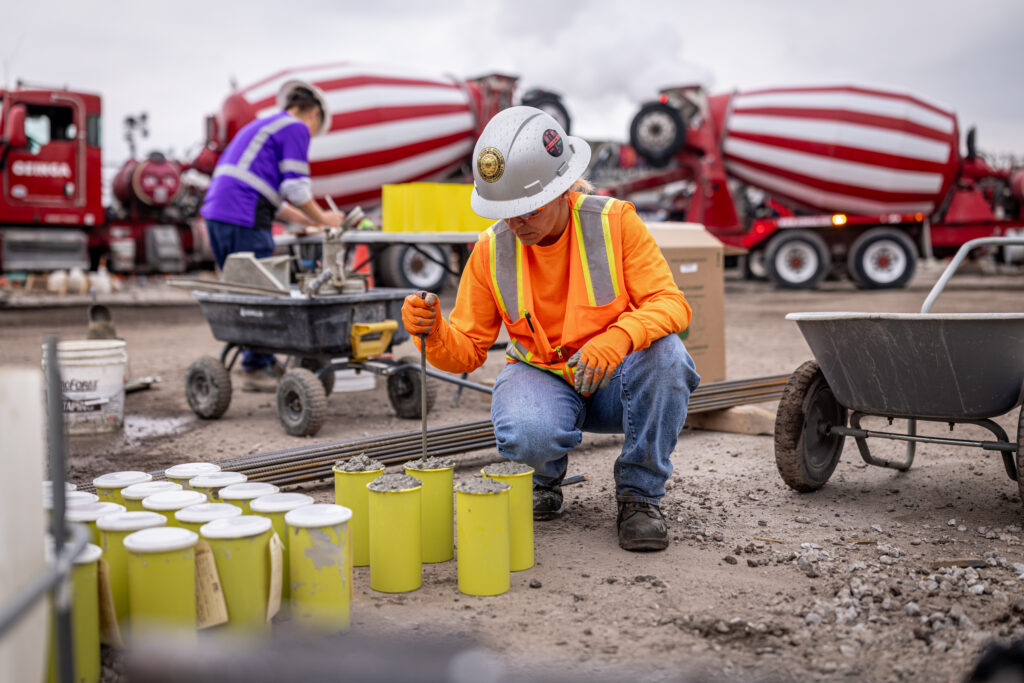

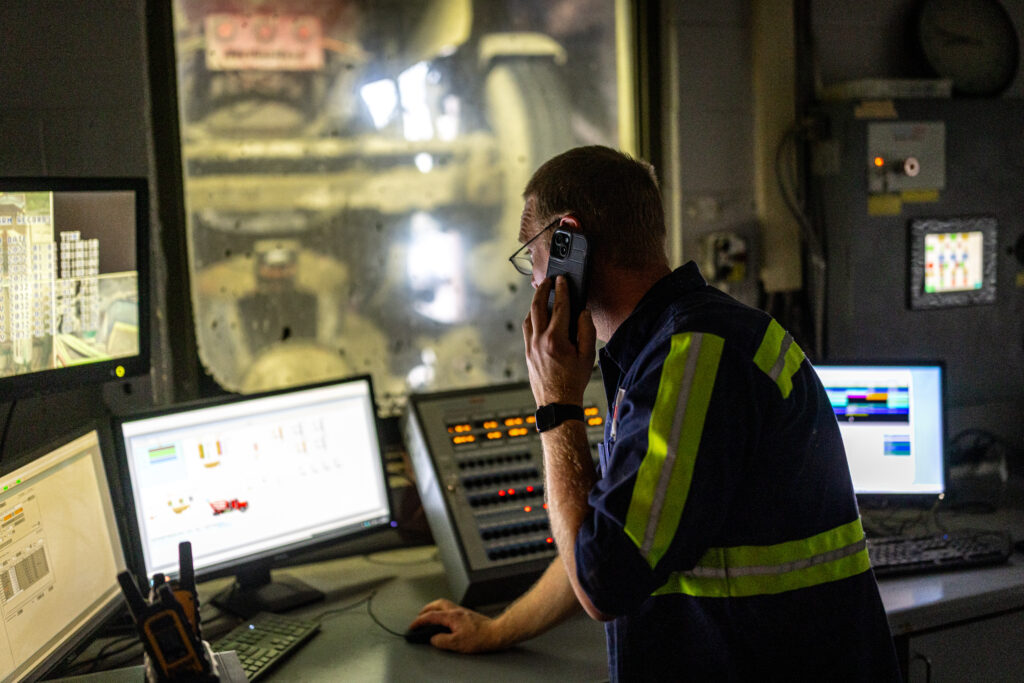

Dispatchers played a critical role throughout the day, constantly monitoring and adjusting delivery timing and spacing. This real-time coordination ensured that concrete arrived at the optimal pace to serve Lindblad’s needs without creating bottlenecks or delays. Quality control measures were implemented at every stage to guarantee that all concrete met the facility’s stringent specifications.
Result
The continuous mat foundation pour commenced at 5:00 AM as scheduled and continued successfully throughout the entire day. Ozinga delivered 185 loads of concrete without a single rejected load, demonstrating the effectiveness of the quality control measures and pre-pour planning. No safety issues were reported during the operation, reflecting the careful adherence to protocols and the comprehensive safety planning that preceded the pour.

The seamless coordination between Ozinga’s plants, dispatchers, drivers, and Lindblad Construction’s team enabled the project to meet its tight timeline while maintaining the highest standards of quality and safety. The successful execution of this challenging pour reinforced the value of thorough planning, clear communication, and reliable service in complex industrial projects.
Conclusion
This project exemplifies how strategic planning, operational coordination, and reliable service delivery combine to achieve success on complex construction projects. By bringing together expertise across dispatching, safety, quality control, and operations, Ozinga provided the support necessary to complete a demanding continuous pour under challenging conditions.
This partnership demonstrates Ozinga’s commitment to serving customers with precision and reliability, regardless of project complexity. The successful execution of 185 concrete loads with zero rejections and no safety incidents reflects the quality of planning and coordination that defines Ozinga’s approach to customer service.

As construction projects continue to present unique logistical and operational challenges, Ozinga remains committed to providing solutions that meet demanding specifications while maintaining the highest standards of safety and quality. Our people and our planning make the difference in delivering successful outcomes for our customers.
